• Home
  • News
  • Engineering
  • Knowledge Hub
  • Resources
No Result
View All Result
Newsletter
Construction Front | Industry Knowledge Hub, News Portal
  • Engineering
  • News
  • Knowledge Hub
  • Resources
  • Contact Us
  • About us
Construction Front | Industry Knowledge Hub, News Portal
  • Home
  • News
  • Engineering
  • Knowledge Hub
  • Resources
No Result
View All Result
Newsletter
Construction Front | Industry Knowledge Hub, News Portal
No Result
View All Result
Home Knowledge Hub
Construction infographic showing how two-stage tendering works, with Stage 1 contractor selection, PCSA execution, Stage 2 preconstruction development, and the final construction contract.

How Two Stage Tendering Works? (And When to Use it)

Denys S. by Denys S.
April,2026
in Knowledge Hub, Procurement and Contract Models
0 0
0
51
SHARES
464
VIEWS
Share on EmailShare on TwitterShare on LinkedinShare on Facebook

On many construction projects, the hardest procurement decision is often when to ask the market for a final price. If the contractor is required to submit a fully fixed price too early, the bid may include large contingencies for design uncertainty, procurement risk, and incomplete information. If the client waits too long, the project may lose time, market interest, momentum, or even become commercially unviable.

A two-stage tender is a procurement route in which the client appoints a contractor in two phases: first, at Stage 1, by selecting a preferred contractor based on capability, methodology, team, programme, and limited commercial inputs; and then, at Stage 2, by engaging that contractor typically under a Pre-Construction Services Agreement (PCSA) to provide early contractor involvement and help develop the design, project documents and final pricing before the main construction contract is agreed.


This guide how the two stage tender works, when it is used, how it relates to Design and Construct (D&C), Construction Manager at Risk (CMaR), and Guaranteed Maximum Price (GMP), and what the main commercial advantages and risks are in practice.

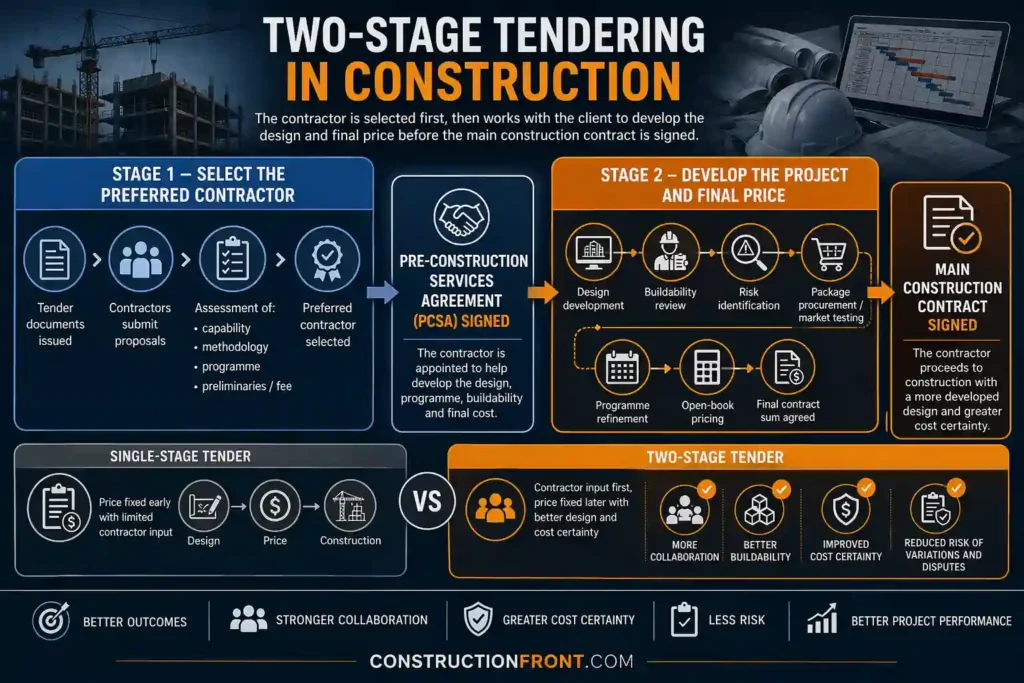

How does two-stage tendering work?

In practice, Stage 1 is the competitive process used to select the preferred contractor. Once that selection is made, the parties usually execute the PCSA and move into Stage 2. During this preconstruction phase, the contractor works with the client to refine the design, programme, package strategy, constructability, risk allocation, and pricing before the main construction contract is signed.

Construction infographic showing how two-stage tendering works, with Stage 1 contractor selection, PCSA execution, Stage 2 preconstruction development, and the final construction contract.
Two-stage tendering first selects a preferred contractor, then uses a PCSA-led preconstruction phase to refine design, scope, programme, risk, and price before the main construction contract is signed.

Stage 1: selection of the preferred contractor

At Stage 1, the client usually runs a competitive process to identify the preferred contractor. Because the design is often still incomplete, the contractor is not normally being asked to submit a final fixed price for the whole project. Instead, the assessment tends to focus on capability, team, delivery approach, and limited commercial inputs.

For example, where a project involves a complex stadium, solar farm, transport asset, or industrial facility, the client will often place significant weight on relevant experience, delivery performance, team capability, and the contractor’s ability to manage similar design, logistics, and programme risks.

Typical Stage 1 tender submissions may include:

  • methodology
  • programme approach
  • key staff and project team
  • design management proposals
  • constructability and logistics thinking
  • relevant experience
  • package procurement strategy
  • preliminaries
  • overheads and profit
  • pricing assumptions
  • limited package pricing or early works pricing

As the Crown Commercial Service worked example makes clear, Stage 1 is primarily a contractor selection exercise rather than a final price commitment.

End of Stage 1: execution of the PCSA

At the end of Stage 1, the client will usually appoint the preferred contractor under a pre-construction services agreement, or PCSA.

The PCSA is the contract used to engage the contractor during the preconstruction phase before the main works contract is signed. It usually sets out the scope of the preconstruction services, fee structure, programme, deliverables, information requirements, pricing process, and the route to agreeing the final construction contract.

That distinction matters. The contractor is usually not yet engaged under the main construction contract at this stage. Instead, it is engaged under the PCSA so that Stage 2 can be used to refine the commercial and technical position of the project.

Two-stage tendering infographic showing Stage 1 contractor selection, the signing of a Pre-Construction Services Agreement (PCSA), and Stage 2 collaborative design development, pricing and final contract agreement before construction begin
In a two-stage tender, the client first selects a preferred contractor, then appoints that contractor under a PCSA to help develop the design, programme, buildability and final cost before the main construction contract is signed.

Stage 2: preconstruction development

Stage 2 is the preconstruction phase carried out under the PCSA. This is the stage in which the contractor works with the client and consultant team to develop the project to the point where the final contract sum and main contract terms can be agreed.

During Stage 2, the contractor may help:

  • refine the design
  • improve constructability
  • sequence the works
  • test logistics and temporary works assumptions
  • engage with the supply chain
  • tender work packages
  • review long-lead items
  • develop the construction programme
  • support value engineering
  • clarify risk allocation
  • build up the final contract sum

This part of the process often involves open-book pricing, package-level review, programme development, and discussion of assumptions and risk allowances.

End of Stage 2: execution of the main construction contract

If Stage 2 is successful, the parties then execute the main construction contract. Depending on the project, that may be a lump sum contract, a target cost arrangement, or in some cases a Guaranteed Maximum Price (GMP) mechanism.

A simplified summary looks like this:

PhaseMain purposeTypical outcome
Stage 1Select the preferred contractorPreferred contractor identified
End of Stage 1Execute the PCSAContractor engaged for preconstruction services
Stage 2Refine scope, programme, risk, and priceFinal commercial and technical position developed
End of Stage 2Execute main construction contractContractor formally appointed for delivery of the works

What are EOI and PQQ in this context?

An Expression of Interest (EOI) is usually an early market invitation used to identify interested and suitable bidders. A Pre-Qualification Questionnaire (PQQ) is a structured prequalification process used to assess capability, experience, financial standing, and other selection criteria before formal tenders are invited.

An EOI or PQQ may sit ahead of a two-stage tender, but neither should be confused with the two-stage tender itself. They are only early filtering tools. The two-stage tender is the process that begins when the client moves into preferred contractor selection and the structured preconstruction phase leading to the final contract.

Why do clients use two-stage tendering?

Clients usually use two-stage tendering where they want earlier contractor involvement but do not want to move immediately into a fully negotiated single-source construction contract. In practice, it is often used where:

  • the design is not yet complete
  • programme pressure makes early contractor input valuable
  • constructability and logistics are important and may influence the design approach
  • specialist subcontractor involvement is needed early
  • the market is difficult or volatile
  • package strategy needs development before final pricing
  • a one-stage fixed-price tender would likely attract heavy contingency

Two-stage tender vs single-stage tender

The core difference is timing. Under a single-stage tender, the contractor is typically asked to submit a final price at the outset. Under a two-stage tender, the contractor is selected first, then works with the client to further develop the project and the final commercial position.

FeatureTwo-stage tenderSingle-stage tender
Contractor selectionEarlierLater
Final price timingLaterEarlier
Constructability input before contractHigherLower
Design maturity required at tenderLowerHigher
Risk of contingency pricingUsually lowerUsually higher
Procurement simplicityLowerHigher

The issue is not which route is always better. It is which route better fits the maturity, urgency, complexity, and risk profile of the project.

How does a two-stage tender relate to ECI?

A two-stage tender is best understood as a procurement route used to achieve early contractor involvement. ECI is the broader concept. It describes the early involvement of the contractor so that it can contribute to design, buildability, sequencing, procurement planning, and risk management before the main construction contract is finalised.

Two-stage tendering is one of the most common ways of doing that. So the relationship is close, but they are not identical. ECI is the broader delivery philosophy, while two-stage tendering is one procurement route used to implement it.

How does it relate to D&C, CMaR, progressive design-build, and GMP?

A two-stage tender is not usually a delivery model in its own right. It is better understood as a route to appointment that can sit alongside different contract structures, which can be achieved in many ways.

It often overlaps with Design and Construct (D&C), especially where the preferred contractor is selected before the design is fully resolved and then helps shape the final design position before the D&C contract is signed. It also sits close to progressive design-build, where the design-builder is selected early and the project is progressively developed before the final commercial commitment is made.

There is also strong overlap with Construction Manager at Risk (CMaR), particularly where Stage 2 culminates in a Guaranteed Maximum Price (GMP) or other later-developed pricing mechanism.

The key point is that two-stage tendering describes the procurement sequence, while D&C, progressive design-build, and CMaR describe broader contractual or delivery structures.

Why contractors may prefer two-stage tendering

Contractors often prefer two-stage tendering where the project is too immature for a sensible fixed-price offer at tender stage. Under a one-stage route, contractors may need to guess unresolved design issues, carry contingency for unknowns, or make aggressive assumptions to remain competitive.

Under a two-stage route, they usually have more time to understand the project before committing to the final price. That may allow:

  • better understanding of scope and sequencing
  • earlier supply chain engagement
  • more realistic package pricing
  • reduced need for blind contingency
  • better visibility of programme risk
  • more meaningful input into buildability and logistics

It is also worth noting that Stage 1 tendering can be less resource-intensive for contractors because they are not being required to fully price every unresolved risk at the outset. In addition, because a PCSA is usually in place for Stage 2, the contractor is typically paid to help develop the project and final commercial position, although the exact payment mechanism will depend on the terms of the PCSA.

Commercial advantages of two-stage tendering

The main advantages are usually practical rather than theoretical. A well-run two-stage tender can provide:

  • better constructability and sequencing input, which can lead to more efficient design outcomes
  • more realistic pricing because the contractor has a better understanding of the design and project requirements
  • improved package planning
  • earlier supply chain engagement, which may improve commercial outcomes
  • better handling of long-lead items
  • more transparent pricing where open-book methods are used

Main risks and drawbacks

Two-stage tendering also comes with real commercial risks. The main drawbacks usually include:

  • loss of direct price competition after Stage 1, because only one contractor typically proceeds to Stage 2
  • difficult or prolonged Stage 2 negotiations, which may stall project progress and delay construction or even investment approval
  • unclear PCSA scope or deliverables
  • weak governance over package tendering and open-book review
  • client overreliance on the preferred contractor
  • weaker negotiating leverage if Stage 2 does not go well
  • risk that design development outruns commercial agreement

Once the preferred contractor is appointed, the client typically no longer has the same live competitive pressure it had at Stage 1. That means the PCSA needs to preserve fallback options if the parties cannot agree the final contract price or terms. In practice, that may include mechanisms dealing with:

  • price ceilings or commercial benchmarks
  • treatment of tendered package prices
  • open-book access to pricing build-up
  • retender rights if Stage 2 fails
  • ownership and use of Stage 2 outputs
  • clear off-ramp rights if the relationship breaks down

Commercial and contractual implications

As with any procurement route, two-stage tendering brings a number of commercial and contractual implications for both clients and contractors during both the procurement phase but also in the future project delivery.

Price certainty comes later

The client does not receive a final construction contract sum at the same point it would under a single-stage tender. That is not automatically a weakness, but it does mean the organisation must be comfortable with progressive pricing rather than immediate price lock-in. On some projects, that may directly affect whether the client is ready to proceed to a final investment decision.

Scope development becomes critical

Because the price comes later, the quality of Stage 2 scope development matters much more. If the project team does not define what is actually being priced, the Stage 2 negotiation can become difficult very quickly.

The PCSA matters more than people think

The PCSA is not just a holding arrangement. It is the contract that governs the preconstruction phase and preserves the client’s commercial position before the main works contract is signed. That is why it should deal clearly with services, deliverables, assumptions, package tendering, fees, programme, and fallback rights such as off-ramp clauses.

Contract administration starts early

Because the contractor is engaged earlier, commercial discipline also needs to start earlier. If pricing assumptions, design decisions, package awards, records, notices, and programme impacts are not properly managed during Stage 2, the same problems may later reappear during construction through variation requests, variation orders, extension of time claims, and broader construction claims and contract administration issues.

Practical examples of two-stage tendering

A few recent examples help show how the model is used in practice:

  • GIICA Shortlists Two Bidders for the New Brisbane Stadium Under ECI Contract Model: a useful example of how some clients are trying to preserve competitive tension deeper into the process by retaining more than one bidder for part of the early contractor involvement phase.
  • Ark Energy Appoints Elecnor as ECI Contractor for Richmond Valley Solar & BESS Project: an example of early contractor involvement being used on an energy project where design, constructability, packaging, and programme development are commercially important before final execution.
  • AECOM Hunt-Turner JV Appointed as Construction Manager for Kay Bailey Hutchison Convention Center Expansion in Dallas: a practical example of an early appointment model sitting close to construction management and preconstruction services.

What projects suit two-stage tendering best?

As a practical rule, two-stage tendering is often better suited to:

  • complex projects
  • partially developed scope
  • projects with major buildability or logistics issues, where contractor expertise can strongly influence the design
  • schemes requiring early supply chain input
  • projects with programme pressure
  • projects involving long-lead packages
  • clients capable of managing Stage 2 actively and commercially

It is generally less suitable where:

  • the scope is already sufficiently mature for a clean fixed-price tender
  • the client wants the earliest possible hard price certainty above all else
  • the organisation is not equipped to manage the Stage 2 process properly
  • there is no credible fallback strategy if negotiations fail

Final thoughts

A two-stage tender is best understood as a procurement route under which the client first selects a preferred contractor, then enters into a PCSA, then uses Stage 2 to refine the design, programme, package strategy, risk position, and final contract price before executing the main construction contract.

Its main strength is that it allows earlier contractor involvement without forcing a premature final price. Its main weakness is that once Stage 1 ends, competitive tension reduces and the client needs much stronger commercial discipline during Stage 2.

In short, a two-stage tender is not just a slower tender or a longer shortlist process. It is a different procurement strategy. Used well, it can improve pricing realism, buildability, and delivery planning. Used badly, it can simply defer procurement problems rather than solve them.

FAQ

What is a two-stage tender in construction?

A two-stage tender is a procurement process where the client first selects a preferred contractor and then engages that contractor under a pre-construction services agreement to help develop the project before the main construction contract is signed.

Is the PCSA executed at the end of Stage 1?

Usually, yes. In a typical two-stage tender, Stage 1 ends with selection of the preferred contractor and execution of the PCSA. Stage 2 is then carried out under that PCSA.

What happens during Stage 2?

During Stage 2, the contractor helps refine the design, construction programme, package strategy, buildability, risk position, and final contract sum. If agreement is reached, the parties then execute the main construction contract.

How is a two-stage tender different from a single-stage tender?

In a single-stage tender, the contractor usually submits a final price at the outset. In a two-stage tender, the contractor is selected first and the final price is developed later.

Is a two-stage tender the same as ECI?

Not exactly. ECI is the broader concept of involving the contractor early. Two-stage tendering is one procurement route commonly used to achieve that.

When should a client avoid a two-stage tender?

A client should think carefully before using it where the project is already mature enough for a straightforward fixed-price tender, where the organisation cannot manage Stage 2 properly, or where there is no credible fallback if final agreement is not reached.

Need Help?

Do not hesitate to contact us (click here) for specialised advice in the construction industry.

Sources

    • RICS, Tendering Strategies, 1st edition
      https://www.rics.org/content/dam/ricsglobal/documents/standards/tendering_strategies_1st_edition_rics.pdf
    • Crown Commercial Service, Worked Example: Two Stage Tendering
      https://assets.crowncommercial.gov.uk/wp-content/uploads/Worked-Example-Two-Stage-Tendering.pdf

    • Almohassen, A. S. et al., Evaluating Construction Contractors in the Pre-Tendering Stage Through an Integrated-Based Model https://www.sciencedirect.com/science/article/pii/S1110016823008645
    • Construction Front, What is an ECI Contract?

    • Construction Front, Design and Construct (D&C) Contracts

    • Construction Front, Construction Manager at Risk (CMaR)

    • Construction Front, Progressive Design-Build

    • Construction Front, Guaranteed Maximum Price

    • Construction Front, Managing Contractor

    • Construction Front, Construction Claims and Contract Administration

    • Construction Front, What is a Variation Order?

    • Construction Front, What is a Variation Request?

    • Construction Front, What is a Time Bar Clause?

    • Construction Front, Notice of Delay

    • Construction Front, What is an Extension of Time Claim (EOT)?

    • Construction Front, What is a Latent Condition in Construction?

Disclaimer: The articles on this blog are for informational and educational purposes only and do not constitute legal or technical advice. While we strive to provide accurate and up-to-date information on construction law, regulations may vary by jurisdiction, and legal interpretations can change over time.

Tags: ECIProcurement and Contract Models
Previous Post

CIP commences construction on 1,500 MWh Patache BESS project in Chile

Next Post

Williams kicks off construction on NESE Project in the U.S. Northeast

Denys S.

Denys S.

Denys Schwartz is a civil engineer and certified professional (PMP, CP3P, CAIA) with more than 15 years of experience in the construction industry, specialising in construction contracts, procurement, claims, delay analysis, and contract management for major infrastructure and energy projects. He holds a postgraduate degree in Corporate Finance and has worked on multibillion-dollar projects across Australia, Brazil, and other international markets — including the Sydney Metro and major renewable energy programs — supporting projects from development, transactions, and procurement through to delivery, claims, and dispute resolution

Related Posts

pre_construction_services_contract_infographic_900x600pre_construction_services_contract_infographic_900x600
Knowledge Hub

How a Pre-Construction Services Contract (PCSA) Works (And When to Use It)?

by Denys S.
April,2026
Construction infographic comparing GMP and lump sum contracts, showing GMP as a later price ceiling with higher transparency and evolving scope, versus lump sum as an earlier fixed price with mature scope and early risk transfer
Knowledge Hub

GMP vs Lump Sum in Construction: What’s the Difference?

by Denys S.
April,2026
Editorial infographic explaining what a Guaranteed Maximum Price means in construction, showing a GMP cost cap above direct costs, contractor fee, contingency, and owner cost certainty.
Knowledge Hub

What Is a Guaranteed Maximum Price (GMP) in Construction? (And How It Works?)

by Denys S.
April,2026
nfographic showing the two-phase structure of progressive design-build, with early collaborative development in Phase 1 and construction execution in Phase 2
Knowledge Hub

What Is Progressive Design-Build? How It Works and When to Use It

by Denys S.
April,2026
construction_claims_contract_administration_final_guide
Claims & Contract Administration

Contract Administration and Construction Claims Explained

by Denys S.
April,2026
Next Post
Williams kicks off construction on NESE Project in the U.S. Northeast

Williams kicks off construction on NESE Project in the U.S. Northeast

alligator creek solar farm - aerial view

Heelstone reaches financial close and starts construction on Alligator Creek and Murch solar projects in the U.S.

pre_construction_services_contract_infographic_900x600pre_construction_services_contract_infographic_900x600

How a Pre-Construction Services Contract (PCSA) Works (And When to Use It)?

Leave a Reply Cancel reply

Your email address will not be published. Required fields are marked *

I agree to the Terms & Conditions and Privacy Policy.

Stay Connected

Join our newsletter!

Newsletter

Newsletter

Stay at the front of the construction industry with the latest news, market trends, and project insights — delivered by ConstructionFront.com

Name
Enter your email address
LinkedIn Twitter Youtube Instagram Facebook Flirk

All about the construction world: the latest industry news and trends, practical knowledge, and unique tips to help you on your projects.

Site Map

  • Home
  • News
  • Engineering
  • Knowledge Hub
  • Resources
  • Contact Us
  • About us

Recent Posts

Red Oak Campus - Data Centre Map

DataBank secures $2 billion financing for Red Oak data centres in Dallas

April,2026
pre_construction_services_contract_infographic_900x600pre_construction_services_contract_infographic_900x600

How a Pre-Construction Services Contract (PCSA) Works (And When to Use It)?

April,2026

Copyright © 2023 ConstructionFront.Com | Affiliate Disclosure | Privacy Policy | Terms & Conditions

Welcome Back!

Login to your account below

Forgotten Password?

Retrieve your password

Please enter your username or email address to reset your password.

Log In
No Result
View All Result
  • Home
  • News
  • Engineering
  • Knowledge Hub
  • Resources

Copyright © 2023 ConstructionFront.Com | Affiliate Disclosure | Privacy Policy | Terms & Conditions

This website uses cookies. By continuing to use this website you are giving consent to cookies being used. Visit our Privacy and Cookie Policy.

ConstructionFront.com - Newsletter!

Stay at the front of the construction industry with the latest news, market trends, and project insights — delivered by ConstructionFront.com

Name
Enter your email address

Thanks, I’m not interested

Privacy Policy - Terms and Conditions
